- Even if it is very early, I would be interested to hear the comments of the knowledgeable people in this forum about what is seen in that video.
What is that yellowish stuff that can be seen on the grating here and there?
- Tepco has a PDF report with some explanations (in Japanese but worth a look as figures and photos make it almost understandable):
http://www.tepco.co.jp/nu/fukushima-np/handouts/2015/images/handouts_150413_02-j.pdf

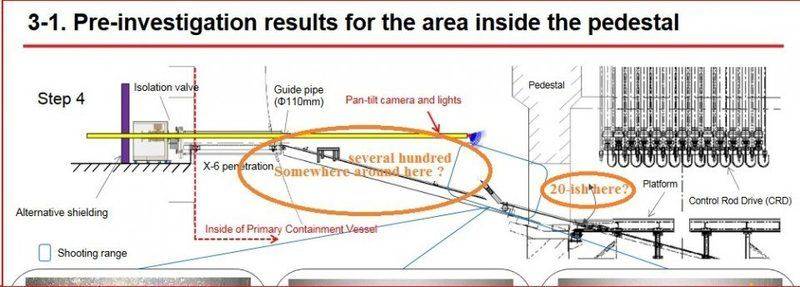

-Page 2 shows the intended route of the robot, out of X-100B penetration and then to the right (anti-clockwise) toward investigation points B0...B17. (The other route, clockwise, from C0 to C11, planned for the other robot, can also be seen.)
-Page 3 mentions that the actual course (blue line) had to be corrected because of obstacles fallen on the grating, and that the robot got stuck somewhere around point B14. Green X signs mark the place of major obstacles. The 20mm scale shown on photos helps understand the size of some of those fallen objects (I don't know why but from the video I wrongly assumed they were much larger).

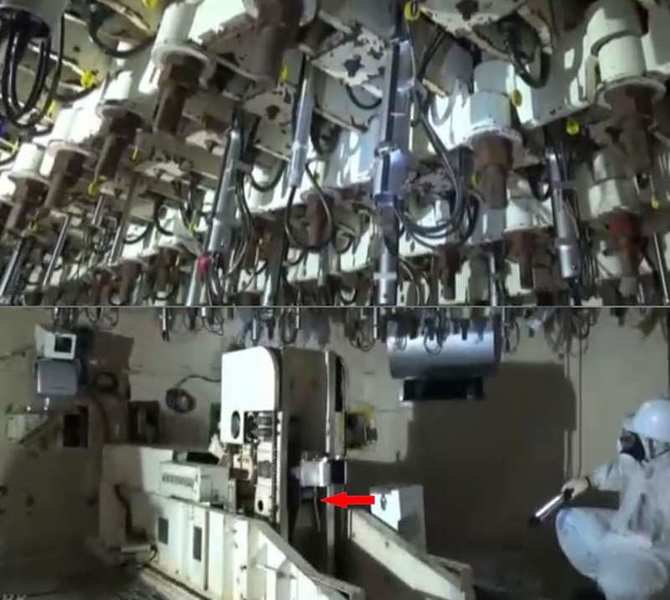

- Page 4: report on results regarding objectives 1 to 3 of the present investigation. (1) Access opening in the grating towards the lower floor was found to be in good condition, without major obstacles (in view of the planned investigation of the basis of the pedestal). (2) CRD rail (?) was not reached but there is some filming of CRD from the last point where the robot was active (images being processed now). (I don't know why this CRD rail was a major objective, I don't even know what it is.) (3) Along the traveled route no major destruction was observed; the HVH, PLR piping, walls of the pedestal showed no signs of major damage. Temperature and radiation values were measured along the way. (I don't know right now what HVH, PLR abbreviations stand for.)
- Page 5: Again we see the opening planned to be used to lower the robot down towards the basis of the pedestal. No major obstacles in the area.

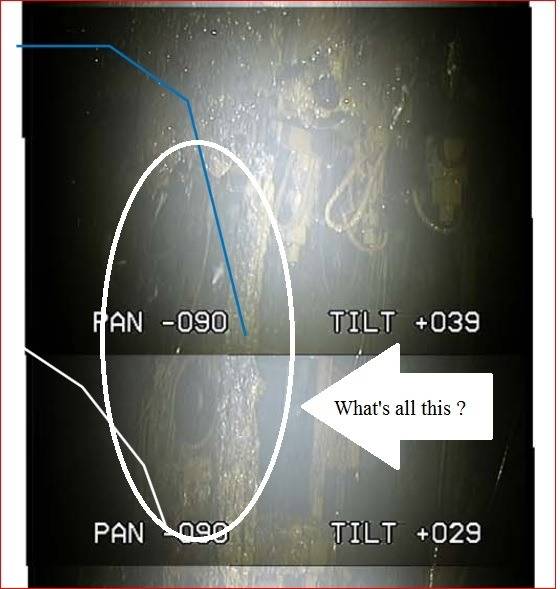

- Page 6: Images from point B7. No major damage on the PLR piping (insulation). However there is some insulation material (?) fallen down on the grating.
- Page 7: View of the outside wall of the pedestal, in good shape (B3). View of the outside of the "machinery hatch" (?), in good shape, no major damage (B2).
- Page 8: Views from B1 point. No major destruction of HVH (D).

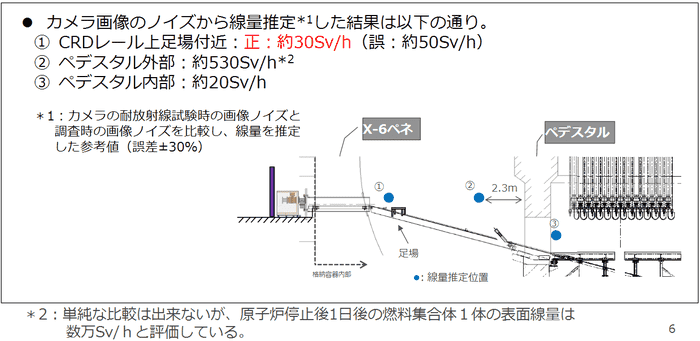

- Page 9: Radiation and temperature measurements.
- Page 10: In the narrowest portion of the route (between points B14 and B15) an obstacled was found and an alternative route was chosen. That's when the robot got stuck. But it managed to take some images in the direction of the CRD. Probable cause - robot rollers stuck in some uneven place formed between preexisting piping and the grating.
- Page 11: They measured about 10 Sv/h and under and are happy to see that the camera resisted 2-3 hours under such conditions. The second part of the investigation is being reconsidered to make use of the information achieved until now. A tentative schedule shows 13 to 17 April as the time window for this second attempt.
- Page 12: Mockup image showing the place where the robot got stuck.
- Page 13: Mockup image showing the CRD rail.
